From the blog

Kanban vs Scrum for Software Delivery Teams: Which Fits Your Workflow?

19 min read
Kanban vs Scrum for Software Delivery Teams: Which Fits Your Workflow?

Quick answer

For software teams, Kanban vs Scrum is mainly a question of how work enters the system. Scrum gives a team a short period in which to pursue a product goal and review a usable result. Kanban helps it manage work that keeps arriving, with explicit rules for capacity and flow. A team building a planned product change may benefit from the first arrangement; a team handling production requests alongside project work may need the second. Look at the work that actually arrived last month, including interruptions, before choosing either one.

Start with the official definitions

The Scrum Guide calls Scrum a lightweight framework for complex work. A Product Owner orders a Product Backlog; Developers create a usable Increment during a Sprint; and the Scrum Team inspects the outcome with stakeholders before adapting. The Sprint is fixed in length at one month or less. Scrum also defines three accountabilities, five events, and commitments tied to its artifacts. Its purpose is not to turn a two-week estimate into a contract. A Sprint Goal gives the team a reason to focus, while the exact scope can be renegotiated as it learns.

The Kanban Guide defines Kanban as a strategy for optimizing the flow of value through a process. It requires a defined and visualized workflow, active management of work items, and ongoing improvement. Teams must make their start and finish points, workflow states, WIP control, movement policies, and service level expectation explicit. Kanban is therefore more than moving cards across a board. It asks whether work is aging, where queues form, and when the system has capacity to pull in the next item.

The practical difference between Scrum and Kanban is where the team puts its operating boundary. In Scrum, the Sprint Goal gives the team a near-term outcome to protect and review. In Kanban, capacity and movement policies determine when work can enter and move through the system. These are not substitutes for a product strategy or sound engineering. They are ways to make different kinds of delivery problems easier to see and manage.

Kanban vs Scrum at a glance

The visual below shows the core structural difference: Scrum organizes delivery around a fixed Sprint rhythm and goal, while Kanban manages work as a continuous pull-based flow.

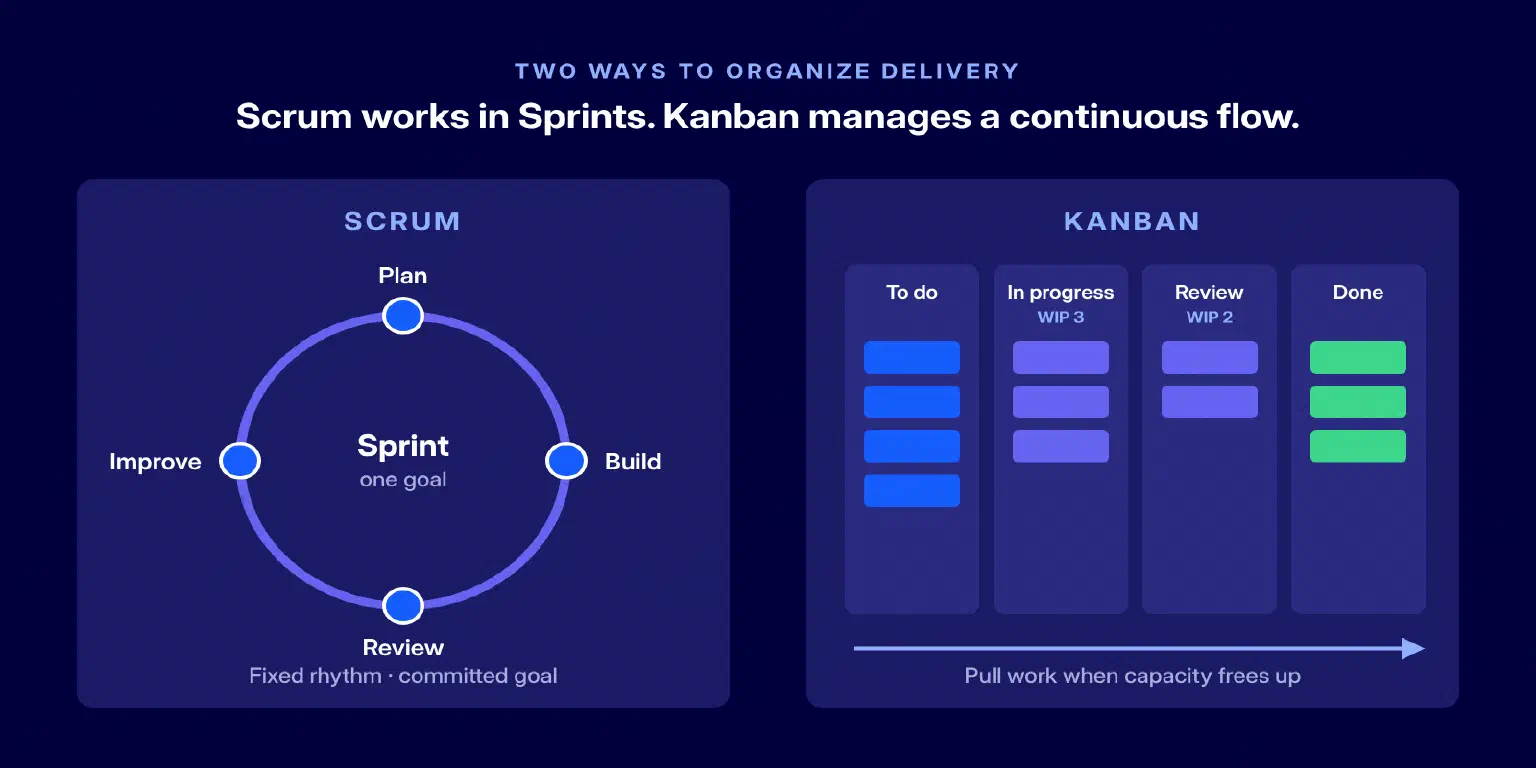

Figure 1. Scrum’s Sprint-based delivery cycle compared with Kanban’s continuous flow.
Figure 1. Scrum’s Sprint-based delivery cycle compared with Kanban’s continuous flow.

This distinction shapes how each method handles planning, work selection, commitments, change, and measurement. The table below compares those decision points in more detail.

Decision pointScrumKanban
Operating rhythmFixed-length Sprints, with planning, daily inspection, review, and retrospectiveContinuous flow; review and replenishment cadence is set by the team
Work selectionDevelopers select work for a Sprint in support of a Sprint GoalNew work is pulled when the workflow has capacity under its WIP control
Changes to prioritiesThe plan can change, but changes must not endanger the Sprint GoalPriorities can be revisited as work is replenished, under explicit policies
RolesProduct Owner, Scrum Master, Developers are defined accountabilitiesNo prescribed roles; existing responsibilities can remain
Constraint to protectA coherent Sprint Goal and a usable IncrementExplicit workflow policies and control of work in progress
Useful evidenceGoal progress, usable increments, stakeholder feedback, quality, and flow within the SprintWIP, throughput, work-item age, cycle time, and service level expectation
Usually worth testing whenWork can be grouped around a product objective and a review rhythm adds valueWork arrives continuously or interruptions make Sprint goals unstable

Read this Kanban vs Scrum comparison as a set of working choices, not a meeting-count contest. Scrum does not require a team to hold a release until the Sprint Review, and Kanban does not prevent quarterly planning or scheduled customer reviews. Ask which commitment needs protection: the near-term product goal, or the capacity of a service that must respond as requests arrive.

The real decision is the shape of your work

Two engineering teams can sit in the same company and still have very different delivery problems. A billing product team may have enough control over its backlog to build and review a self-service change every two weeks. The platform team that supports it may spend those same weeks handling access requests, failed deployments, incident follow-up, and planned reliability work. Applying one planning rule to both teams makes reporting consistent on paper; it does little for either team if their intake behaves differently.

For the product team, a Sprint Goal can protect an outcome such as “customers can update a payment method without support.” For the platform team, a fixed Sprint plan may be repeatedly displaced by urgent requests. Google’s SRE guidance on on-call work describes production events that can take priority over project work; that is a useful reminder that some interruptions are part of the service, not evidence of poor discipline.

The easiest way to avoid a theoretical argument about Scrum or Kanban is to look at the last few weeks of tickets. Count what was planned, what arrived afterward, and what genuinely needed immediate attention. Then check size and dependencies. An access fix that takes an hour and an architecture change that takes weeks should not disappear into the same average cycle-time number. The team may need separate classes of work before it needs a new method.

The comparison below shows why two teams in the same organization may need different workflow controls. Product work can often be shaped around planning boundaries, while service work may arrive continuously.

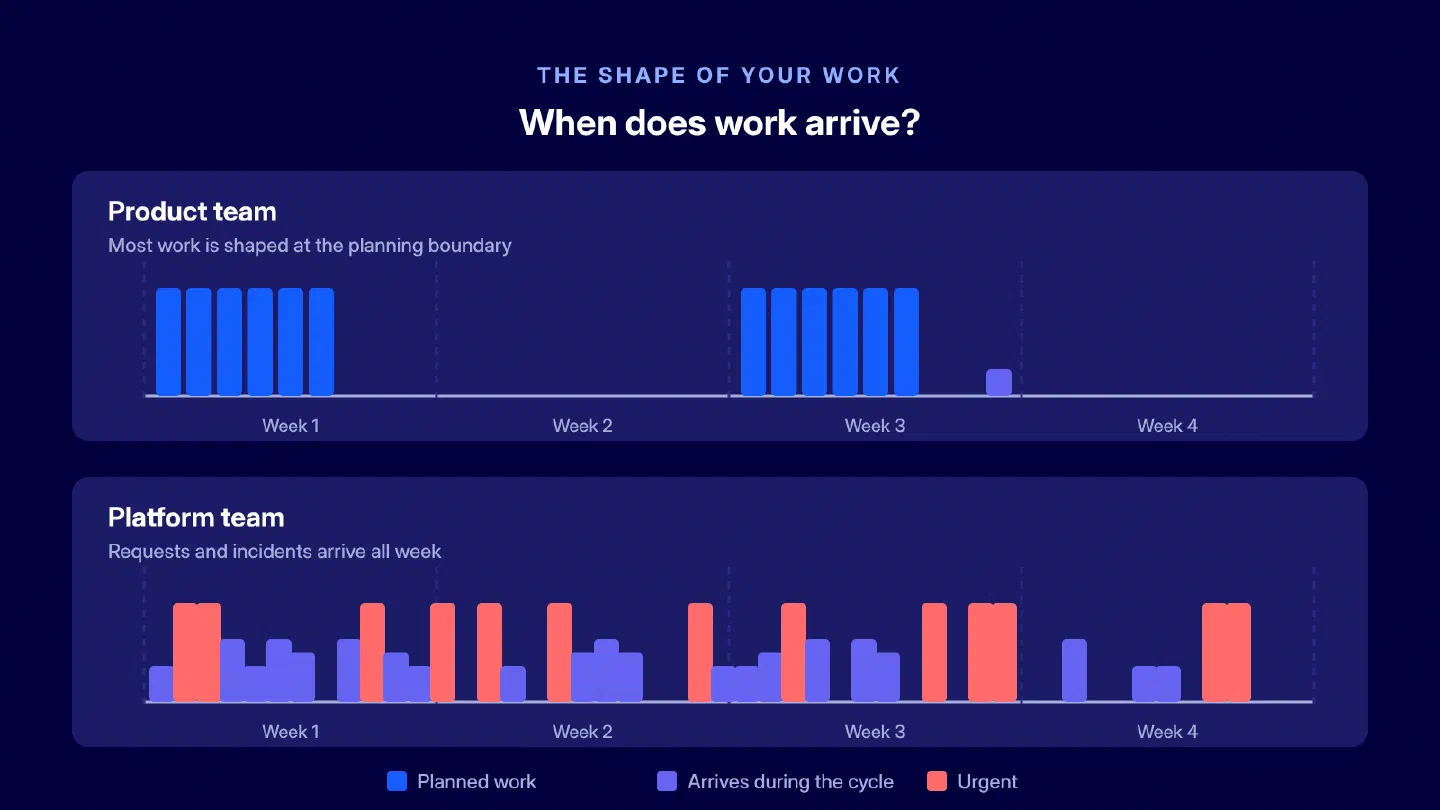

Figure 2. Work arrival patterns for a product team and a platform team.
Figure 2. Work arrival patterns for a product team and a platform team.

Work arrival is only the first signal. The matrix below also considers interruptions, item size, stakeholder rhythm, dependencies, planning horizon, and the team’s main delivery problem.

The workflow-shape matrix below is a discussion tool, not a validated industry benchmark. Put each dimension in the column that best matches your team’s recent work; a mixed row means you need to investigate, not force a score.

What to inspectScrum-leaning signalKanban-leaning signal
Work arrivalMost work can be shaped before a planning boundaryImportant work arrives throughout the week
InterruptionsUrgent requests are rare or handled by a protected rotationInterruptions are frequent and legitimately time-sensitive
Item sizeWork can usually be sliced into a usable Sprint incrementSizes vary widely, including small operational requests
Stakeholder rhythmA recurring review helps decide what to build nextStakeholders need response times and status continuously
DependenciesThe team can coordinate around one near-term product goalThe team often waits on multiple services or external owners
Planning horizonA short-term objective remains relevant through the SprintPriorities change before a Sprint ends
Main pain todayWeak focus or late product feedbackQueues, aging work, too much WIP, or unpredictable response time

Treat the matrix as a prompt for discussion, not a team-type rule. A platform team can run Scrum if an incident rotation protects its Sprint Goal; a product team can use Kanban if small changes are released and reprioritized continuously. The useful finding is the constraint to test next, whether that is interruptions, item size, review capacity, or the way work is admitted.

When Scrum is the better starting point

Scrum is worth testing when the team can turn a product objective into a usable increment within a Sprint and the people at the review can make decisions about what comes next. Those conditions matter more than whether the calendar already contains the right ceremonies. The Product Owner must be able to make trade-offs, Developers need room to finish the work, and stakeholders need to see a working result rather than a status slide.

Take a payments team replacing a manual refund workflow. A two-week goal might be to enable support agents to issue a partial refund with an audit trail. The team can change implementation details during the Sprint and still preserve that outcome. At the review, support can test the workflow, identify missing exception cases, and influence the next slice. The value of Scrum here is the repeated loop between a concrete product result and informed feedback.

Watch what happens when every Sprint fills with unrelated tickets and the goal repeatedly yields to urgent work. Before replacing Scrum, find out whether the team has an intake problem, work items too large to finish, product decisions that arrive late, or dependencies outside its control. A board with continuous-flow columns will display those problems, but it will not resolve them on its own.

When Kanban is the better starting point

Kanban is often easier to operate when work arrives throughout the week and not every request deserves the same response time. That is common in platform services, maintenance, developer enablement, and support. The team still plans; it just makes a different decision explicit: what can be pulled now, given the work already underway and the service expectations attached to it?

Imagine a platform team with six items in review, two waiting for security approval, and several new deployment requests. A Kanban system makes “ready to pull,” “in progress,” “review,” and “blocked” meaningful states, then sets a policy for how much work can be active at once. The team can decide to finish older reviews before starting another migration task. It can also distinguish an urgent production incident from a routine request without allowing every stakeholder to mark their item urgent.

If the board fills up but nobody agrees when to stop starting, when an item is ready to move, or which aging item needs help, the team has visualized its queue without managing it. The Kanban Guide defines no specific roles or recurring events, but it does require teams to manage work actively under explicit policies. That distinction matters in Kanban versus Scrum evaluations that focus too heavily on meeting load.

Measure the workflow, not adherence to a label

The Kanban Guide identifies four required flow metrics. They should earn their place in the team’s conversation: an aging item might need an owner, rising WIP might call for a pause on new starts, and a longer cycle-time tail might change what the team can credibly promise. A service level expectation (SLE) is related but distinct. It states a time period and probability based on historical cycle time; it is not a fifth required flow metric.

SignalWhat it tells youA useful management question
Work in progress (WIP)How many started items are not finishedIs the team starting more than it can finish?
ThroughputHow many items finish per unit of timeIs the delivery rate stable for comparable work?
Work-item ageHow long a current item has been in progressWhich active items need attention before they miss the SLE?
Cycle timeHow long completed items took from start to finishHas the typical time or its spread changed?
SLEA forecast such as “85% of items finish within eight days”Is today’s aging work approaching an agreed risk threshold?

The table defines what each signal means. The work item age view below shows how those signals become actionable by revealing which active items are aging in each workflow stage.

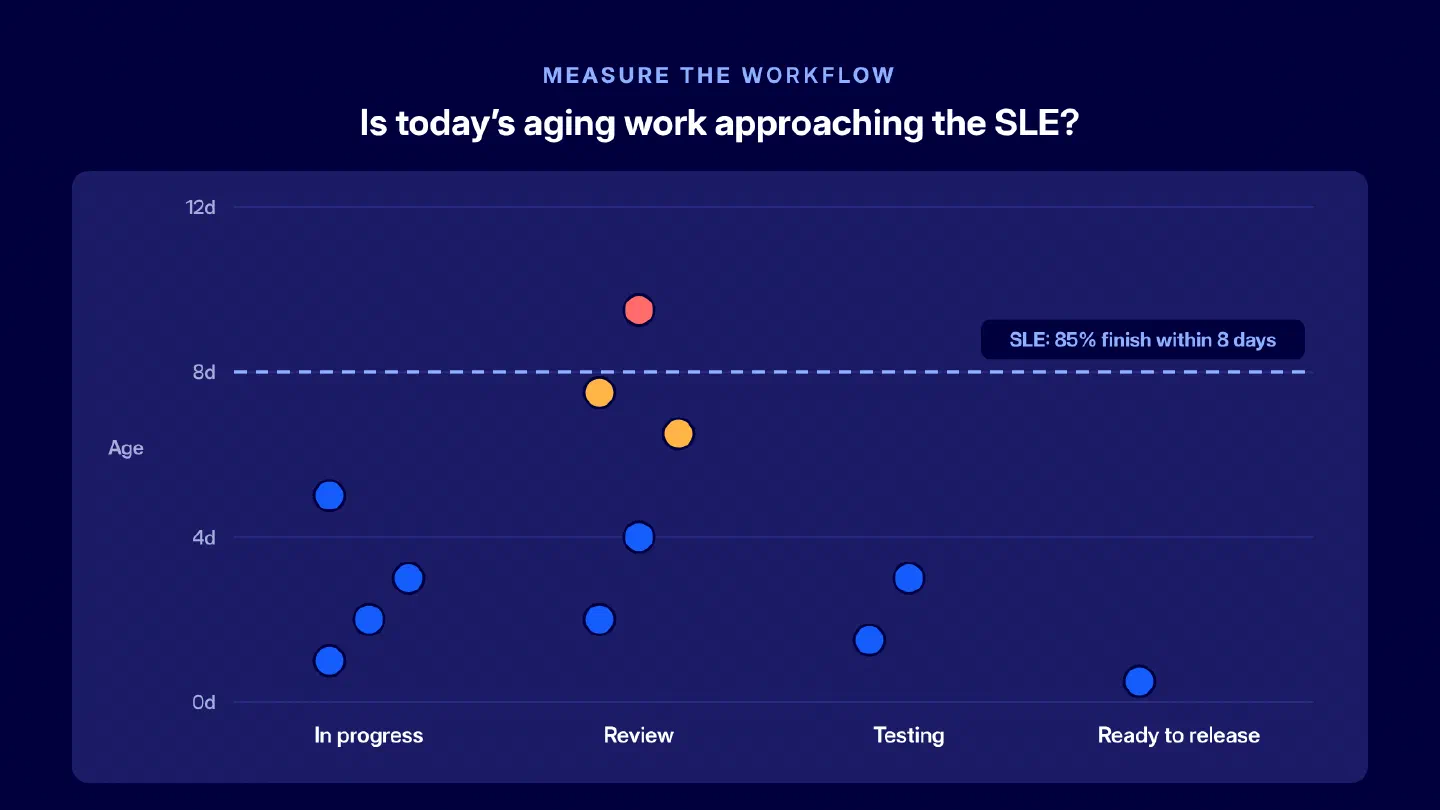

Figure 3. Work item age by workflow stage, highlighting items that need attention.
Figure 3. Work item age by workflow stage, highlighting items that need attention.

Here, the oldest items in review deserve attention even if the overall median cycle time is improving.

Suppose the median cycle time improves, yet several customer-facing requests take twice as long as before. Reporting only the median would make the change look successful while hiding the service problem. Define the start and finish points consistently, separate unlike work such as bug fixes and migrations, and look at the slow tail as well as the typical item.

For a Scrum team, the share of story points closed says little on its own about the value delivered. At the review, look at the Sprint Goal, the usable increment, what stakeholders learned, and whether quality held. Do not wait until the end of the Sprint to notice a review queue: work-item age can reveal a likely miss while there is still time to respond. Velocity can help the same team make a local plan, but differences in point scales and work mix make it a poor way to rank teams.

DORA’s guidance on choosing measurement frameworks makes the broader point that a team should choose measures that fit its organizational goals and can guide improvement. For this Scrum vs Kanban comparison, that means checking whether the chosen process helps the team deliver valuable work reliably, rather than rewarding perfect compliance with a ceremony or board policy.

Kanban vs Scrum pros and cons in practice

OptionAdvantage when it fitsCost when it does not
ScrumProtects a near-term product goal and creates regular inspection with stakeholdersSprint plans become performative if legitimate urgent work constantly replaces planned work
KanbanMakes queues, aging, and capacity visible as work arrivesContinuous reprioritization can crowd out strategic work without explicit policies and review cadence
Scrum with Kanban practicesKeeps the Sprint Goal while exposing WIP and flow constraints inside the SprintExtra rules can become process overhead if no specific bottleneck is being addressed

A tidy Sprint board can mask weak delivery, while continuous flow can crowd out strategic work. Judge both methods by what gets delayed when urgent demand arrives.

Common Scrum and Kanban Myths: True or False?

Misconceptions often make teams compare methodology labels instead of the conditions in which work is delivered. The table below separates common claims from what Scrum and Kanban actually require.

ClaimVerdictWhat is actually true
Scrum prevents teams from changing anything during a Sprint.FalseThe Sprint Goal should remain stable, but scope can be clarified and renegotiated as the team learns more.
Kanban means accepting every new request immediately.FalseExplicit policies and WIP limits determine when new work can be pulled. Urgent requests should follow a defined policy rather than bypass the system.
Velocity measures a Scrum team’s productivity.FalseVelocity is a local planning aid. It should not be used to rank teams or replace evidence about outcomes, quality, and Sprint Goal success.
Kanban has no planning, commitments, or deadlines.FalseKanban teams still plan capacity and priorities. Historical cycle time and service level expectations can support delivery forecasts with stated probabilities.
Using a board means a team is practicing Kanban.FalseA board only visualizes work. Kanban also requires a defined workflow, explicit policies, active WIP control, and continuous improvement.
Scrum is for product teams, while Kanban is only for support teams.It dependsThe better fit depends on work arrival, interruptions, item size, feedback cadence, and the constraint the team needs to protect, not the team’s label.

The practical question is not which framework is more correct, but which constraint the team needs to manage. Once the misconception is removed, teams can combine practices deliberately, for example by protecting a Sprint Goal while limiting WIP in review.

Can a team combine them?

Yes. Kanban practices can complement Scrum. A Scrum team can define its workflow, limit work in review, watch item age, and use cycle-time history in Sprint planning. It still retains the Scrum accountabilities, events, and commitments. A team that uses a few Scrum-like reviews alongside a Kanban system can also benefit, but calling every mixture “Scrumban” does not explain how it works.

Start with a specific failure. When a review queue puts the Sprint Goal at risk, a review WIP policy gives the team a reason to finish or unblock work before opening more of it; work-item age will show whether that helped. When a service team responds quickly to requests but postpones reliability work, a scheduled portfolio review can protect those investments. The hybrid has value if a new practice changes one of those decisions, not because the team has collected more ceremonies.

A seven-question scorecard for your team

Use the following worksheet with the team, product owner or service owner, and a delivery stakeholder. Mark S when the first answer is closer to reality, K when the second is, and ? when the evidence is missing. The marks guide a conversation, not an automatic verdict.

  1. Can most upcoming work be shaped before a short planning period (S), or does important work arrive continuously (K)?
  2. Can urgent requests be isolated without losing the near-term objective (S), or must the whole team respond frequently (K)?
  3. Are items generally small enough to form a usable increment within a Sprint (S), or do sizes and service classes vary widely (K)?
  4. Does a recurring stakeholder review materially improve product direction (S), or is continuous service feedback more important (K)?
  5. Is weak focus the main problem (S), or is work aging in queues despite everyone being busy (K)?
  6. Can the team maintain a meaningful Sprint Goal through the period (S), or does that goal regularly become irrelevant (K)?
  7. Is the key promise a product outcome for the next review (S), or a dependable response time across ongoing requests (K)?

Split answers are worth investigating rather than averaging into a verdict. The product team might need a dedicated interrupt rotation, while the platform team may need protected capacity for larger engineering investments. The difference between Kanban and Scrum becomes useful once the team can say which part of its work needs a different rule.

Test method fit with a four-to-six-week experiment

Give a process change a testable purpose. If too much work waits in review, for example, record the current queue and item ages before adding a WIP control. Four to six weeks usually provides several observations for teams working in weekly or two-week rhythms; a longer planning or service cycle needs more time. Keep the definition of a work item stable during the test, or you may mistake a reporting change for an improvement.

The visual below turns the pilot into four steps: establish a baseline, change one constraint, observe several cycles, and decide what to do next.

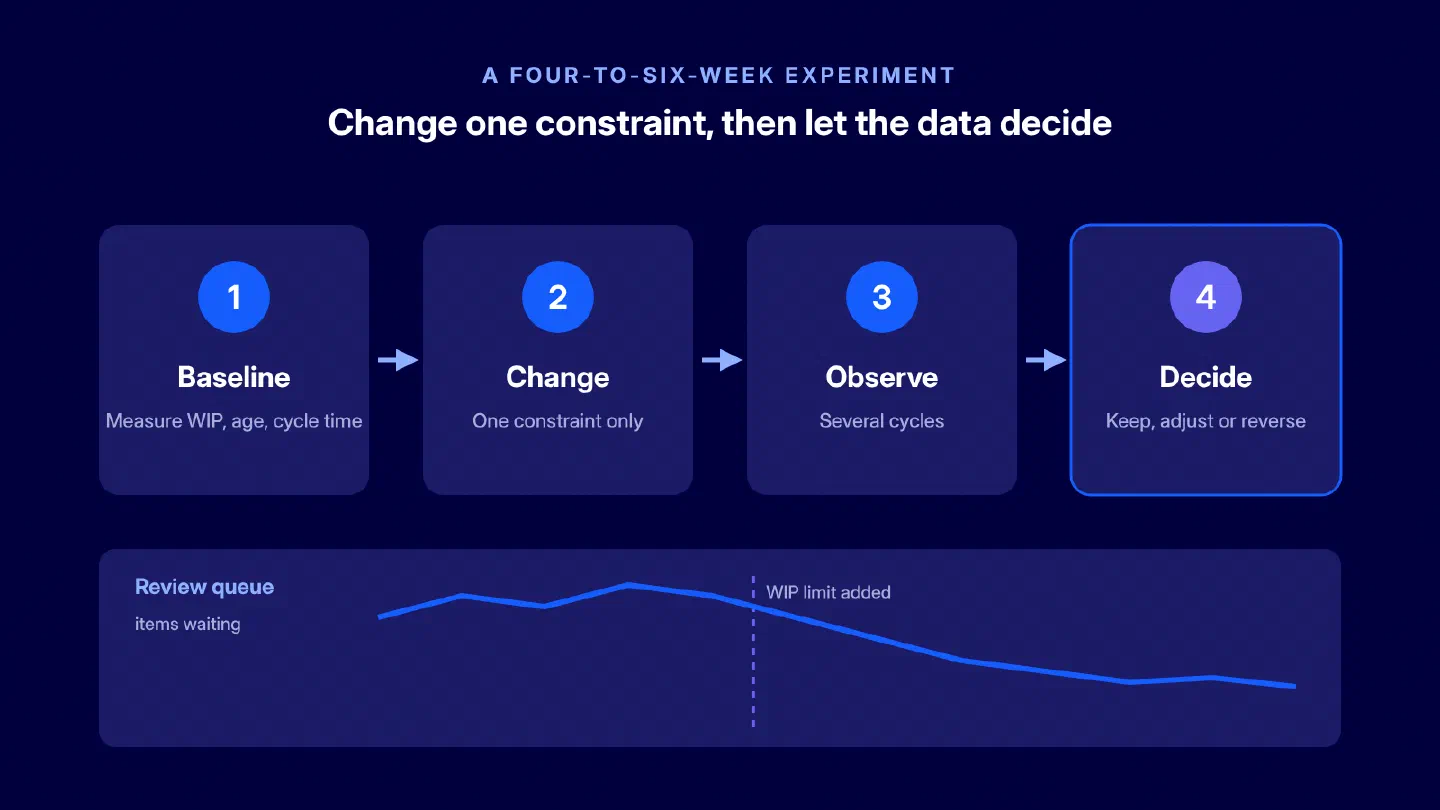

Figure 4. A four to six week workflow experiment from baseline to decision.
Figure 4. A four to six week workflow experiment from baseline to decision.

The table below translates the same sequence into the actions and evidence required at each stage.

StageWhat the team doesEvidence to review
BaselineExamine recent work by type; define start and finish; note WIP, age, cycle time, throughput, blocked time, goal success, and spillover where relevantVariation and recurring delays, not just averages
Change one constraintExamples: protect a Sprint Goal with an interrupt rotation, or introduce a review WIP controlWhether the intended policy was actually used
Observe several cyclesReview active aging items weekly and completed items at the end of each cycleHas the bottleneck moved, and are quality and service outcomes intact?
DecideKeep, adjust, or reverse the changePredictability, stakeholder value, and sustainability together

The trade-off matters as much as the headline metric. If a WIP control shortens cycle time but urgent incidents now wait longer, the service has not necessarily improved. A Scrum team might complete fewer planned tickets yet deliver a better increment after stakeholders identify the right product change. Review the business outcome alongside the flow numbers before keeping or reversing the experiment.

This is also where engineering delivery analytics can help. When a queue grows, the delivery question is not simply whether the team followed Scrum or Kanban; it is which initiative now depends on that queue, what stage is holding it up, and whether its expected completion date has moved.

How AndonPulse helps turn a workflow signal into a decision

An item-level board is useful for the team doing the work. A delivery leader has a different question: which initiative is affected, what depends on it, and is the completion estimate still believable? AndonPulse connects data from existing planning and engineering tools into initiative, project, task, and workflow-stage views. Its integrations let managers investigate delivery in the tools teams already use, without asking engineers to maintain another status report.

Consider the platform team’s review queue. In AndonPulse, a manager can move from an initiative showing delivery risk to the tasks and workflow-stage durations behind it, then check whether the delay is concentrated in review or spread across the workflow. That gives the next conversation a concrete starting point: who owns the pending reviews, which dependency needs attention, and should the team stop starting new work? After an intervention, the same view helps the manager see whether the queue and initiative outlook improve. The platform supplies context and visibility; the manager still chooses the response.

The same view can put a missed Sprint Goal in context. Was the planned feature waiting in review, displaced by urgent work, or blocked by another initiative? AndonPulse makes that distinction more visible across tools and teams. Leaders can therefore discuss the source of delay and its effect on a business commitment, instead of treating the methodology label as the diagnosis.

Final takeaway

Choose a workflow around the demand the team actually receives, and change it if the evidence says it is not working. Scrum can protect a product objective long enough to deliver and review a usable increment. Kanban can help a team handle continuous intake without losing sight of WIP, aging work, or service expectations. Many teams will borrow from both. The test is whether customers get the expected outcome and the team can spot a delivery problem early enough to do something about it.

FAQ

What are the main Kanban vs Scrum differences?
The main Kanban vs Scrum differences are cadence and the constraint each method protects. Scrum works through Sprints and a Sprint Goal; Kanban controls WIP and manages continuous flow. Both can use boards and flow metrics.
Kanban vs Scrum: which is better for software teams?
A feature team with a stable short-term objective may benefit from Scrum; an interrupt-driven service team may benefit from Kanban. Inspect work arrival, interruptions, and the outcome the team owes before choosing.
Can Scrum and Kanban be combined?
Yes. A Scrum team can add WIP control and work-item age without dropping Scrum’s accountabilities or events. Combine practices to address a specific bottleneck, not to collect process.
Is Kanban just a board with columns?
No. The official guide requires a defined workflow, WIP control, movement policies, and an SLE. The board visualizes those rules; the team still has to manage and improve the flow.
Can a support or SRE team use Scrum?
Yes, if it can protect a meaningful Sprint Goal while handling urgent demand. When incidents repeatedly displace planned work, test continuous flow or a separate interrupt rotation.
Which metrics belong in a Scrum vs Kanban comparison?
Kanban requires WIP, throughput, work-item age, and cycle time. For Scrum, inspect the Sprint Goal, usable increments, progress toward the Product Goal, quality, and stakeholder feedback. Flow measures can help either team.
Does Kanban mean no planning or deadlines?
No. Teams still plan capacity and priorities. Historical cycle time can support an SLE, a delivery-time forecast with a stated probability. Make the basis and uncertainty of any commitment visible.
Should velocity decide whether a team uses Scrum or Kanban?
No. Velocity can help one team plan; it is not a universal productivity score. Compare outcomes, quality, and flow instead of ranking teams by story points.
How long should a team test a new workflow?
Test over several delivery cycles. Four to six weeks can reveal whether a change to WIP, intake, or Sprint protection affects aging and predictability. Longer cycles need a longer test.
